How can an energy owner assess whether an LNG start-up date is realistic?
Assess whether evidence and a forecast support first LNG by the planned date, including system readiness, EPC handovers, approvals and supplies.
Key takeaways: For LNG owner-side commissioning leads and project directors, a realistic start-up date is one the evidence supports across the systems, approvals and supplies needed for first LNG. Work backwards through those dependencies with EPC and operator reviewers, then forecast whether the remaining work can finish in time.
In April 2025 a carrier brought a cargo of imported LNG into Kitimat, British Columbia, so that LNG Canada could test its equipment before the plant had begun operations. The company described offloading that cargo for equipment testing as "critical to the safe start-up and commissioning process in advance of operations," and its first export cargo left the facility on June 30, 2025. These start-up milestones show how much remains beyond construction progress. Our work with LNG Canada supported construction only; the later commissioning and export events illustrate a separate set of dependencies.
A first LNG date depends on construction handing systems over for pre-commissioning and the EPC contractor handing them to the operator's commissioning team. Regulatory approvals, operator readiness and gas supplies run alongside those physical handovers, with their own conditions and lead times. Working back from first LNG makes it easier to see whether all of them support the date.

INSIGHTS PRO · DRIVING PATHS
Upload your commissioning schedule and see the critical and sub-critical paths most likely to move your first LNG date.
Explore Insights ProWhat makes an LNG start-up date realistic?
A start-up date is realistic when completion evidence and a credible forecast of the remaining work support first LNG by that date, at the confidence level the owner requires. To test it, EPC and operator reviewers compare each system's status, remaining tests and dependencies with the schedule, then record whether the evidence supports the date or exposes a gap. An unresolved gap leaves the date unsubstantiated, however thoroughly the review is documented.
The Construction Industry Institute describes commissioning and start-up as "the critical last phase of a capital project before the facility is placed in operation to meet commercial objectives." Responsibility also crosses organizational boundaries: the EPC contractor develops the construction plan, commissioning responsibilities follow the contract, and the owner prepares to operate the plant and secures the necessary approvals from regulators. The schedule needs to connect those responsibilities.
Pin down the milestone you are judging before comparing dates. First LNG from a named train, the first export cargo and commercial operation are separate events. Contracts may require certification of mechanical completion and a ready-for-start-up (RFSU) state system by system before hydrocarbons go in, but the definitions vary, so use the terms your contract sets.
Where can the EPC-to-operator handover put the date at risk?
The handover puts the date at risk when separate construction and commissioning plans leave gaps between them. The Construction Industry Institute's research on commissioning and start-up lists interface management, integration and a systems focus among the critical success factors for the phase.
Check for:
- Completion reported by area or discipline when commissioning needs it by system, so a system can look finished on paper while one of its components is not.
- Punch items carried forward into commissioning without an agreed view of which ones block energization or the introduction of hydrocarbons.
- A commissioning sequence held in a separate plan or spreadsheet, so its logic never links to the construction activities it depends on.
- Operator readiness, such as staffing, training and approved operating procedures, missing from the logic altogether.
- Regulatory approvals and inspections shown as zero-duration milestones rather than activities with lead times and evidence.
- Assumptions about feed gas, refrigerant and cool-down supply that sit with the owner's commercial team rather than in the schedule.
Each gap can move first LNG without being apparent in the construction progress figures.
How do you walk backwards from first LNG?

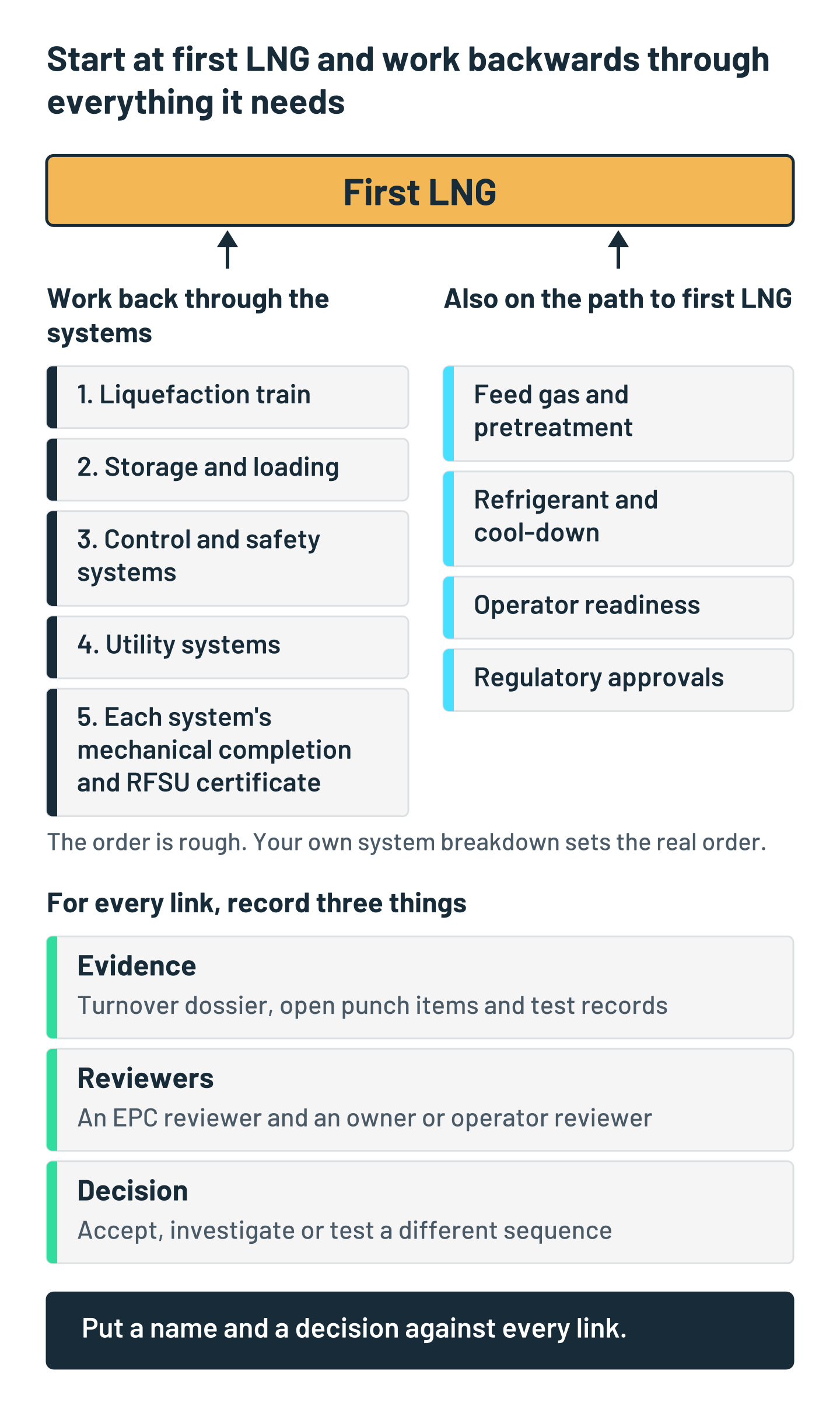

You walk backwards from first LNG by listing every system the liquefaction train needs, in reverse order of need, and asking for each one what the schedule says, what the evidence shows and who has accepted the difference. Repeat it for each train, since later trains carry their own sequence.
Our construction case study with LNG Canada describes two LNG trains, a 225,000 cubic meter storage tank, a marine terminal for two carriers at once and feed gas from the Coastal GasLink pipeline. Those are major facilities and external interfaces, each comprising or depending on many systems and subsystems. The review runs through their electrical, control, safety and utility dependencies system by system.
- Fix the milestone. Agree in writing which event is being forecast: first LNG from a named train, the first export cargo, or commercial operation, and use the contract's own definitions of mechanical completion, ready-for-start-up (RFSU) and handover.
- Connect the plans. Bring construction, commissioning, operator readiness and external approvals into one logic-linked schedule, or at least link them at every handover point.
- List the systems in reverse order of need. Start from the liquefaction train and work back, roughly through storage, loading, control and safety systems to the utility systems the process units depend on, and on to each system's mechanical completion and RFSU certificate. Your own system breakdown sets the real order.
- Compare status with evidence. For each system, set the schedule's reported status beside the turnover dossier, open punch items and test records, and note every gap.
- Forecast the chain. Run a forecast of the whole path to first LNG and identify the critical and sub-critical paths most likely to drive the date.
- Test feasible sequences. For the systems that drive the date, ask the commissioning team which alternative sequences are safe and practical, then compare their effect on the forecast.
- Record and revisit. Record the evidence, the EPC and operator reviewers and the decision for each system in a handover assurance table, and revisit it at every schedule update.

What goes in a handover assurance table?
A handover assurance table records, for each system dependency on the path to first LNG, the evidence you need, who on each side of the handover is accountable for accepting it, and the decision you reached. Named reviewers can then resolve specific gaps before the next update.
| System | Evidence to ask for |
|---|---|
| Utilities | Turnover certificates for power, fuel gas, nitrogen and instrument air; punch items; tests |
| Flare and relief | Completed testing, outstanding punch items, any approval conditions |
| Control and safety | Loop checks, cause-and-effect testing, outstanding software changes |
| Feed gas and pretreatment | Pipeline readiness, gas quality assumptions, interconnect commissioning plan |
| Refrigerant and cool-down | Refrigerant and LNG supply plan, cool-down procedure, storage and loading readiness |
| Liquefaction train | Contract-defined mechanical completion and RFSU certificates, pre-commissioning records, start-up punch items |
| Operator readiness | Staffed shifts, completed training, approved operating procedures |
| Regulatory approvals | Filed requests, inspection dates, outstanding conditions |
Assign the evidence review to the people accountable for that system or dependency.
| System | EPC reviewer | Owner or operator reviewer |
|---|---|---|
| Utilities | Commissioning lead | Utilities lead |
| Flare and relief | Commissioning lead | Process safety lead |
| Control and safety | Controls lead | Control systems lead |
| Feed gas and pretreatment | Interface manager | Pipeline and commercial lead |
| Refrigerant and cool-down | Commissioning lead | Start-up lead |
| Liquefaction train | Train lead | Train lead |
| Operator readiness | Not required | Operator readiness lead |
| Regulatory approvals | Permitting lead | Regulatory lead |
Record the decision and next action alongside the evidence and reviewer names for every system. These illustrative entries show the format; they are not readiness findings for LNG Canada or another named facility.
| System | Review decision | Next action or condition |
|---|---|---|
| Utilities | Accept | Evidence supports scheduled availability; retain required authorizations |
| Flare and relief | Investigate | Close the testing gap; keep the hydrocarbons gate closed until readiness is accepted |
| Liquefaction train | Test a different sequence | Commissioning lead develops a feasible option for reforecast and acceptance review |
Accept means both reviewers agree the evidence supports the scheduled date. Investigate means the evidence is incomplete or contradicts the schedule, and someone named will close the gap by a stated update. Test a different sequence means the system is likely to drive first LNG and the commissioning team should propose safe alternatives that can be compared on the forecast.
Flare and relief systems must be accepted as ready, with the required tests and conditions satisfied, before hydrocarbons are introduced. An 'investigate' status leaves that gate closed. The owner must also secure each required regulatory authorization before the activity it permits; a review status in the table cannot stand in for that authorization.
How do regulators shape the start-up date?
The owner needs to secure approvals alongside the physical handovers, allowing time for filings, inspections and outstanding conditions. Give each approval an accountable lead and link it to the activity it permits. Apply the rules for the facility's jurisdiction; LNG Canada is in British Columbia.
How do FERC approvals shape a US start-up date?
In the United States, FERC can release commissioning approvals step by step under a project's order. Its Plaquemines letter shows why each required release needs its own place in the start-up logic. A letter from FERC's Office of Energy Projects to Venture Global Plaquemines LNG on November 14, 2024, granted a request to introduce low-pressure fuel gas to the hot oil heaters, "based on FERC staff's on-site inspection," and stated that the approval did not grant authority "to construct, commission, or introduce hazardous fluid to other project facilities at the LNG terminal." Further authorizations would follow only once compliance with the order's conditions was demonstrated.
The same letter reminded the operator that it must also comply with any applicable Department of Transportation requirements under 49 CFR Part 193, the federal safety standards for LNG facilities enforced by the Pipeline and Hazardous Materials Safety Administration. A US start-up schedule should therefore carry each FERC release and the PHMSA requirements as activities with owners, not as a single approval milestone.
How does COMAH shape a start-up date in Great Britain?
In Great Britain, a new upper-tier site cannot start operation until the competent authority has sent its conclusions on the operator's safety report, so that review belongs in the start-up logic. A site holding 200 tonnes or more of liquefied natural gas is an upper-tier establishment under the Control of Major Accident Hazards (COMAH) Regulations 2015. For a new establishment, the operator must send the safety report within a reasonable period before the start of operation, and regulation 9 states that the operator must not start operation until it has received the competent authority's conclusions.
Outside nuclear sites, that competent authority is the Health and Safety Executive and the appropriate environment agency acting jointly, under regulation 4.
What applies in British Columbia, where LNG Canada operates?
British Columbia's Liquefied Natural Gas Facility Regulation requires a safety and loss management program before operation and specified pre-operation inspections and tests. Section 9 requires at least seven days' notice before the specified control, safety, containment and fire-water tests; applicable containment and fire-water results must satisfy the regulator before operation begins. Under section 11, the permit holder must notify its intention to begin operations and satisfy the regulator that sections 8 to 10 have been met. The notice period is at least 14 days, subject to the regulator extending or reducing it. Carry these dependencies and project-specific permit conditions in the start-up schedule.
Where does an independent forecast help the handover review?
An independent forecast helps by showing which of the dependencies in your table are most likely to move first LNG, so the joint team can decide which systems to review first and in most depth while retaining the complete readiness checks. With nPlan Insights Pro, teams upload their schedule and get a forecast for the milestones they care about, such as first LNG, with every activity forecast using what our AI has learned from more than 780,000 past project schedules. Insights Pro identifies which themes and activities influence the outcome the most, and its Driving Paths view visualizes criticality in the schedule based on those forecasts, showing the critical path and the sub-critical paths most likely to affect the milestone.
The forecast then supports the "test a different sequence" decision. Mitigation Strategies, the scenario tester in Insights Pro, lets teams identify, test and communicate the mitigation strategies that give them the best chance of making the date, so each sequence the commissioning team proposes can be compared on the same forecast.
During construction of its Kitimat facility, LNG Canada used our forecasts to focus its risk conversations. The project team described that construction-stage value in our joint case study:
"nPlan is part of our toolkit to help us anticipate risk and capture opportunity on the Project. Using data from thousands of other projects helps highlight areas we (as a project team) may have overlooked and allows us to focus our conversations on the areas that could have the biggest impact."
That case demonstrates construction-stage risk review. For a commissioning review, the forecast findings need testing against turnover dossiers, punch items and site evidence. Commissioning specialists remain responsible for safety and handover acceptance.
When is this approach not enough?
The walk-back method needs a commissioning sequence to walk, so it suits the period from late construction through start-up rather than the investment decision. Before final investment decision, when commissioning logic is still a set of assumptions, an owner is better served by reviewing schedule maturity and the evidence behind the overall forecast. The contract also changes the owner's role. Where the EPC contractor keeps commissioning responsibility until performance testing, the table becomes the owner's assurance record rather than a joint decision log, but its questions stay the same.
What should you do before the next schedule update?
Before the next update, pick the systems that the current forecast says are most likely to drive first LNG, put them in a handover assurance table with named EPC and operator reviewers, and bring the evidence for each to the next joint review. If the evidence supports the date, you can accept it on the record. If not, you know which links to investigate and which sequences to test while there is still time.
For more on AI in energy capital projects, read our conversations with Chevron in Forecasting the future: Chevron's big bet on AI for project success, part I and part II, the overview of nPlan for energy projects, and the comparison of traditional risk software and nPlan.
INSIGHTS PRO · MITIGATION STRATEGIES
Test the commissioning sequences your team proposes against the forecast before you accept a first LNG date.
Book a callFrequently asked questions
Is first LNG the same as commercial operation?
First LNG is the first liquefied product made by a train. A first export cargo of that production follows it, while commercial operation is a separate contractual or commercial milestone. Imported LNG used for equipment testing or cool-down is a different event, so specify which milestone the schedule forecasts.
Should regulatory approvals sit in the start-up schedule?
Yes. Give each approval its own lead time, evidence and owner-side lead, linked to the activity it authorizes. In the US, FERC can release these approvals step by step after inspections, as its Plaquemines letter shows. In Great Britain, a new upper-tier COMAH establishment must not start operation until it has the competent authority's conclusions on its safety report.
Who should own the handover assurance table?
The owner should hold the table, with a named EPC reviewer and a named operator reviewer recorded against every system. Where the contract leaves commissioning with the EPC contractor until performance testing, the table becomes the owner's assurance record for contractual conversations rather than a jointly owned decision log.
Can an AI forecast confirm that a start-up date will hold?
No. A forecast shows how likely the date is and which activities and paths most threaten it, based on the schedule you upload. It cannot see a punch list that is missing from the schedule or decide that a system is safe to energize, so the commissioning team and the operator still accept each handover.
Sources
- LNG Industry: LNG import cargo arrives at LNG Canada facility (April 3, 2025)
- Shell news release: First cargo leaves LNG Canada (June 30, 2025)
- Construction Industry Institute: Critical success factors for project commissioning and startup (RS312-1, 2015)
- FERC Office of Energy Projects letter to Venture Global Plaquemines LNG, Docket CP17-66-000 (November 14, 2024)
- 49 CFR Part 193: Liquefied natural gas facilities, federal safety standards
- Control of Major Accident Hazards Regulations 2015, regulation 9
- Control of Major Accident Hazards Regulations 2015, regulation 4: the competent authority
- nPlan and LNG Canada: Using AI-led forecasting and risk management to reduce delivery risk during the construction of LNG Canada
- British Columbia, Liquefied Natural Gas Facility Regulation, sections 8 to 11 (consolidation current to October 20, 2026)
- nPlan Insights Pro
- nPlan for energy projects
- nPlan: Forecasting the future, Chevron's big bet on AI for project success, part I
- nPlan: From gravity hazards to cyclone recovery, Chevron's big bet on AI for project success, part II
- nPlan: Traditional risk software vs nPlan

Why AI is more accurate than humans at probabilistic risk forecasting
Alan Mosca and Georgia Stillwell explore how machine learning surpasses human expertise in risk forecasting. They discuss the limitations of human judgment in traditional risk management, emphasizing overconfidence and inaccuracy in estimating probabilities.
